How Long Does It Take To Plumb a House? (2025 Guide)

Home » How Long Does It Take To Plumb a House? (2025 Guide)

If you’re building a new home or planning a major renovation, you’ve probably asked yourself: “How long does it take to plumb a house?” It’s a smart question—plumbing is one of the most critical (and often misunderstood) phases of construction. Delays here can ripple through your entire project schedule. Whether you’re a homeowner, contractor, or DIY enthusiast, understanding realistic plumbing timelines helps you plan better, avoid budget overruns, and ensure your system is safe and code-compliant.


What Does “Plumbing a House” Actually Include?

Before diving into timelines, it’s essential to understand what “plumbing a house” entails. Residential plumbing isn’t just about pipes—it’s a multi-stage process that includes:

  • Rough-in plumbing: Installing supply lines, drain-waste-vent (DWV) systems, and stub-outs before walls are closed.
  • Fixture installation: Adding sinks, toilets, showers, water heaters, and appliances.
  • Inspections & pressure testing: Ensuring everything meets local building codes and functions safely.
  • Final connections: Hooking up to municipal water/sewer lines or septic systems.

This entire process must comply with the International Plumbing Code (IPC) and local regulations—critical for safety and long-term functionality.


How Long Does It Take To Plumb a House? The Real Timeline

The short answer: 3 to 10 days for rough-in plumbing, and 1 to 3 weeks total for a complete plumbing system in a standard single-family home. But that’s just a baseline. Several factors dramatically influence the actual duration.

Key Factors That Affect Plumbing Duration

House sizeA 1,500 sq ft home: ~5 days rough-in. A 3,500+ sq ft custom build: 10–14+ days.
Number of bathroomsEach full bathroom adds 1–2 days of labor.
Plumbing layout complexityOpen floor plans = faster. Multi-story or intricate designs = slower.
Material typePEX is faster to install than copper or PVC.
Permit & inspection delaysCan add 2–5 days if not scheduled ahead.
Weather (for new builds)Rain or freezing temps can delay underground work.

According to the National Association of Home Builders (NAHB), plumbing typically accounts for 5–7% of total construction time in a standard new-build home.

“In my 15 years as a licensed plumber, I’ve seen timelines double when homeowners change fixture locations mid-project,” says Marcus Lee, Master Plumber and owner of Summit Plumbing Co. in Colorado. “Stick to the plan, and you’ll save time and money.”

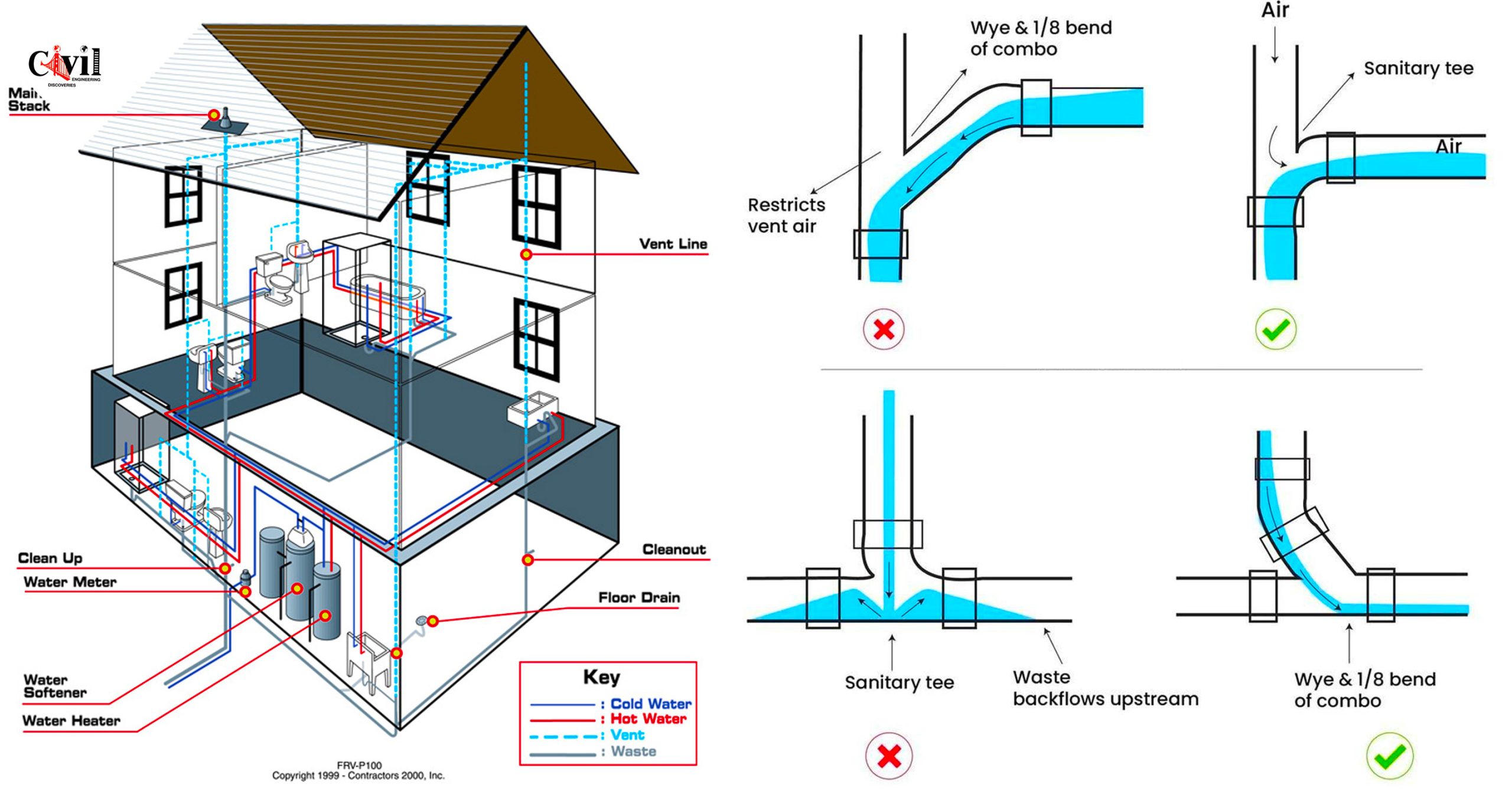

How Long Does It Take To Plumb A House

Step-by-Step: How Plumbing Installation Unfolds

Here’s a realistic, day-by-day breakdown for a 2,000 sq ft, 2.5-bath home:

Day 1–2: Underground Rough-In

  • Trenching for sewer and water lines.
  • Installing main sewer pipe (typically 4-inch PVC) with proper slope (¼ inch per foot).
  • Connecting to city sewer or septic tank.
  • Backfilling trenches.

Note: This stage requires coordination with local utility companies and often needs a separate inspection.

Day 3–5: Above-Ground Rough-In

  • Running DWV pipes through walls and floors.
  • Installing supply lines (usually PEX or copper).
  • Placing stub-outs for future fixtures.
  • Pressure testing all lines (water lines at 80 PSI for 2+ hours; air test for drains).

⚠️ Pro Tip: Always schedule the rough-in inspection before drywall goes up. Failing this can mean tearing open walls—a costly delay.

Day 6–10: Fixture Installation (After Drywall & Flooring)

  • Mounting toilets, sinks, tubs, and showers.
  • Installing water heater, washing machine hookups, and dishwasher lines.
  • Final water and gas connections (if applicable).

Day 11–14: Final Inspection & System Flush

  • City inspector verifies code compliance.
  • Flushing the system to remove debris.
  • Testing all fixtures for leaks and proper drainage.

PEX vs. Copper vs. PVC: Does Pipe Material Affect Time?

Absolutely. The choice of piping material can shave or add days to your project:

PEX⚡ FastestFlexible, fewer fittings, freeze-resistantNot UV-resistant; can’t be used outdoors
CopperModerateDurable, recyclable, high pressure toleranceExpensive; requires soldering skills
PVC/CPVCFast (for drains)Cheap, lightweight, corrosion-resistantBrittle in cold; not for hot water (PVC)

Most modern homes use PEX for water supply and PVC for drains—a combo that balances speed, cost, and reliability.

For more on plumbing materials, see the Wikipedia entry on plumbing .


Common Delays (And How to Avoid Them)

Even the best-laid plans hit snags. Here’s how to stay on track:

  • Change orders: Avoid moving fixtures after rough-in begins.
  • Permit bottlenecks: Apply for plumbing permits early—some cities take 3–7 business days.
  • Subcontractor scheduling: Book your plumber before framing starts.
  • Material shortages: Order pipes and fixtures 2–3 weeks in advance.

A 2024 study by ConstructConnect found that 68% of plumbing delays in residential builds were due to poor coordination—not technical issues.


FAQ: Your Top Questions Answered

Q1: Can plumbing be done in one day?

A: Only for very small projects (e.g., a tiny home or single bathroom remodel). A full house? No—safety and code compliance require multiple stages and inspections.

Q2: How long after plumbing can drywall go up?

A: Drywall can be installed immediately after the rough-in plumbing passes inspection—usually within 24–48 hours of testing.

Q3: Does plumbing take longer in a renovation vs. new construction?

A: Yes. Renovations often involve working around existing structures, removing old pipes, and dealing with unexpected issues (like corroded lines or outdated codes). Add 20–40% more time vs. new builds.

Q4: What’s the average cost to plumb a house?

A: $4,000–$15,000 for a new 2,000 sq ft home, depending on location, materials, and complexity (HomeAdvisor, 2025 data).

Q5: Can I plumb my own house?

A: In most U.S. states, yes—but only if you’re the homeowner and live in the house. However, you’ll still need permits and inspections. Mistakes can lead to leaks, mold, or failed resale inspections. When in doubt, hire a licensed pro.

Q6: How do I know if my plumbing was done correctly?

A: Signs of quality work: no leaks, consistent water pressure, quiet pipes, and passing all inspections. Ask for a certificate of compliance from your plumber.


Conclusion: Plan Smart, Build Smooth

Knowing how long does it take to plumb a house isn’t just about counting days—it’s about understanding dependencies, avoiding pitfalls, and ensuring your home’s plumbing system is safe, efficient, and built to last. Whether you’re managing a custom build or upgrading an older property, clear communication with your plumber and early planning are your best tools.

💡 Found this guide helpful? Share it with a friend who’s building or renovating!
👉 Tag them on Facebook, Pinterest, or LinkedIn—good plumbing knowledge is worth passing on.

By respecting the process and timeline, you’ll enjoy clean water, reliable drainage, and peace of mind for decades to come.If you’re building a new home or planning a major renovation, you’ve probably asked yourself: “How long does it take to plumb a house?” It’s a smart question—plumbing is one of the most critical (and often misunderstood) phases of construction. Delays here can ripple through your entire project schedule. Whether you’re a homeowner, contractor, or DIY enthusiast, understanding realistic plumbing timelines helps you plan better, avoid budget overruns, and ensure your system is safe and code-compliant.


What Does “Plumbing a House” Actually Include?

Before diving into timelines, it’s essential to understand what “plumbing a house” entails. Residential plumbing isn’t just about pipes—it’s a multi-stage process that includes:

  • Rough-in plumbing: Installing supply lines, drain-waste-vent (DWV) systems, and stub-outs before walls are closed.
  • Fixture installation: Adding sinks, toilets, showers, water heaters, and appliances.
  • Inspections & pressure testing: Ensuring everything meets local building codes and functions safely.
  • Final connections: Hooking up to municipal water/sewer lines or septic systems.

This entire process must comply with the International Plumbing Code (IPC) and local regulations—critical for safety and long-term functionality.


How Long Does It Take To Plumb a House? The Real Timeline

The short answer: 3 to 10 days for rough-in plumbing, and 1 to 3 weeks total for a complete plumbing system in a standard single-family home. But that’s just a baseline. Several factors dramatically influence the actual duration.

Key Factors That Affect Plumbing Duration

House sizeA 1,500 sq ft home: ~5 days rough-in. A 3,500+ sq ft custom build: 10–14+ days.
Number of bathroomsEach full bathroom adds 1–2 days of labor.
Plumbing layout complexityOpen floor plans = faster. Multi-story or intricate designs = slower.
Material typePEX is faster to install than copper or PVC.
Permit & inspection delaysCan add 2–5 days if not scheduled ahead.
Weather (for new builds)Rain or freezing temps can delay underground work.

According to the National Association of Home Builders (NAHB), plumbing typically accounts for 5–7% of total construction time in a standard new-build home.

“In my 15 years as a licensed plumber, I’ve seen timelines double when homeowners change fixture locations mid-project,” says Marcus Lee, Master Plumber and owner of Summit Plumbing Co. in Colorado. “Stick to the plan, and you’ll save time and money.”


Step-by-Step: How Plumbing Installation Unfolds

Here’s a realistic, day-by-day breakdown for a 2,000 sq ft, 2.5-bath home:

Day 1–2: Underground Rough-In

  • Trenching for sewer and water lines.
  • Installing main sewer pipe (typically 4-inch PVC) with proper slope (¼ inch per foot).
  • Connecting to city sewer or septic tank.
  • Backfilling trenches.

Note: This stage requires coordination with local utility companies and often needs a separate inspection.

Day 3–5: Above-Ground Rough-In

  • Running DWV pipes through walls and floors.
  • Installing supply lines (usually PEX or copper).
  • Placing stub-outs for future fixtures.
  • Pressure testing all lines (water lines at 80 PSI for 2+ hours; air test for drains).

⚠️ Pro Tip: Always schedule the rough-in inspection before drywall goes up. Failing this can mean tearing open walls—a costly delay.

Day 6–10: Fixture Installation (After Drywall & Flooring)

  • Mounting toilets, sinks, tubs, and showers.
  • Installing water heater, washing machine hookups, and dishwasher lines.
  • Final water and gas connections (if applicable).

Day 11–14: Final Inspection & System Flush

  • City inspector verifies code compliance.
  • Flushing the system to remove debris.
  • Testing all fixtures for leaks and proper drainage.

PEX vs. Copper vs. PVC: Does Pipe Material Affect Time?

Absolutely. The choice of piping material can shave or add days to your project:

PEX⚡ FastestFlexible, fewer fittings, freeze-resistantNot UV-resistant; can’t be used outdoors
CopperModerateDurable, recyclable, high pressure toleranceExpensive; requires soldering skills
PVC/CPVCFast (for drains)Cheap, lightweight, corrosion-resistantBrittle in cold; not for hot water (PVC)

Most modern homes use PEX for water supply and PVC for drains—a combo that balances speed, cost, and reliability.

For more on plumbing materials, see the Wikipedia entry on plumbing .


Common Delays (And How to Avoid Them)

Even the best-laid plans hit snags. Here’s how to stay on track:

  • Change orders: Avoid moving fixtures after rough-in begins.
  • Permit bottlenecks: Apply for plumbing permits early—some cities take 3–7 business days.
  • Subcontractor scheduling: Book your plumber before framing starts.
  • Material shortages: Order pipes and fixtures 2–3 weeks in advance.

A 2024 study by ConstructConnect found that 68% of plumbing delays in residential builds were due to poor coordination—not technical issues.


FAQ: Your Top Questions Answered

Q1: Can plumbing be done in one day?

A: Only for very small projects (e.g., a tiny home or single bathroom remodel). A full house? No—safety and code compliance require multiple stages and inspections.

Q2: How long after plumbing can drywall go up?

A: Drywall can be installed immediately after the rough-in plumbing passes inspection—usually within 24–48 hours of testing.

Q3: Does plumbing take longer in a renovation vs. new construction?

A: Yes. Renovations often involve working around existing structures, removing old pipes, and dealing with unexpected issues (like corroded lines or outdated codes). Add 20–40% more time vs. new builds.

Q4: What’s the average cost to plumb a house?

A: $4,000–$15,000 for a new 2,000 sq ft home, depending on location, materials, and complexity (HomeAdvisor, 2025 data).

Q5: Can I plumb my own house?

A: In most U.S. states, yes—but only if you’re the homeowner and live in the house. However, you’ll still need permits and inspections. Mistakes can lead to leaks, mold, or failed resale inspections. When in doubt, hire a licensed pro.

Q6: How do I know if my plumbing was done correctly?

A: Signs of quality work: no leaks, consistent water pressure, quiet pipes, and passing all inspections. Ask for a certificate of compliance from your plumber.


Conclusion: Plan Smart, Build Smooth

Knowing how long does it take to plumb a house isn’t just about counting days—it’s about understanding dependencies, avoiding pitfalls, and ensuring your home’s plumbing system is safe, efficient, and built to last. Whether you’re managing a custom build or upgrading an older property, clear communication with your plumber and early planning are your best tools.

💡 Found this guide helpful? Share it with a friend who’s building or renovating!
👉 Tag them on Facebook, Pinterest, or LinkedIn—good plumbing knowledge is worth passing on.

By respecting the process and timeline, you’ll enjoy clean water, reliable drainage, and peace of mind for decades to come.
